Concrete
Storm Drainage Canal Rehabilitation El Sexto Anillo, Santa Cruz,
Bolivia
(resumens
de los informes en Espaņol
(PDF
EMT
Engineering
Eric
Krause
Meghan Wahlstrom
Tricia Curmi
International
Senior Design, CE 4990 & 4905 August 2005
|

|
Project
Background
In August, 2005,
a group of Civil/Environmental Engineering students from Michigan
Technological University traveled to Santa Cruz, Bolivia. The International
Senior Design Class has been returning yearly since 2001 to the outskirts
of Santa Cruz to continue solving Civil/Environmental engineering
problems and providing local communities engineering design solutions
to aid in their health and welfare.
This group of 3 students,
EMT Engineering, studied problems associated with a concrete storm
water canal located on the southern outskirts of Santa Cruz. In
the 1980s the City of Santa Cruz constructed the concrete-lined

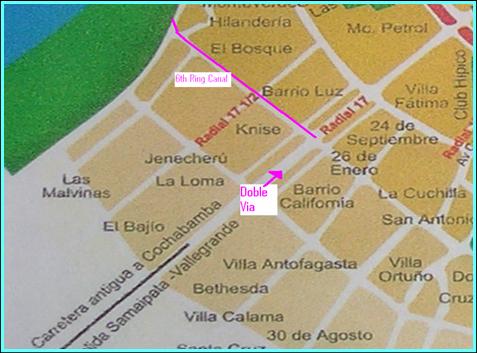

canal along el Sexto Anillo (the 6th Ring road). The canal extends
from Doble Vía Santa Cruz- La Guardia (Road) to a natural
river outlet, approximately 3,000 m (10,000 ft).
The canal carries runoff
from 6th Ring and the surrounding watershed. The City Engineers
of Santa Cruz told EMT the designed slope was sufficient for the
storm water to drain down the canal into the river. However, when
the canal was built, the construction company did not survey to
check the grade; instead they used a hose and running water. Consequently,
the upstream portion is almost flat, but the downstream end of the

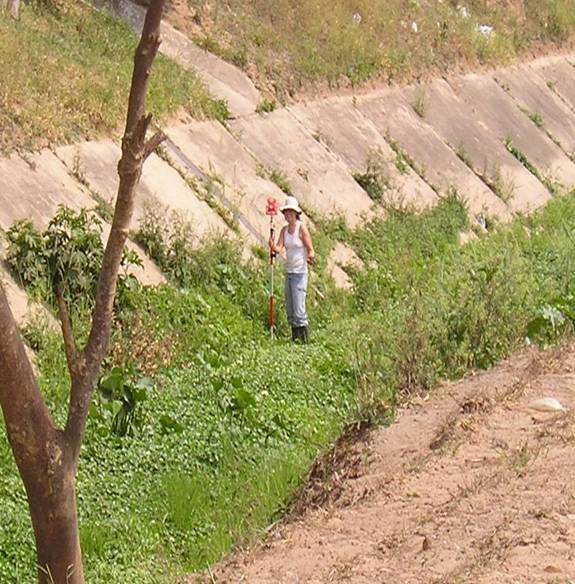

canal has a sufficient grade of 0.5% (per EMT Engineering survey).
Storm water pools at the east end due to this flat grade and creates
more of a water garden than a drainage canal.

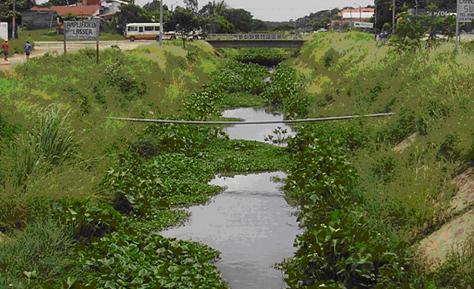

The ponding portion of
the canal is approximately 2,200m (7,200 ft) long. The stagnate
water is not only an eyesore; it also gives off an unpleasant odor,
and poses health and safety risks; including acting as a breeding
ground for malaria-carrying mosquitoes. The city of Santa Cruz has
asked EMT Engineering to produce a design recommendation to rehabilitate
the canal and alleviate this problem.

|

|

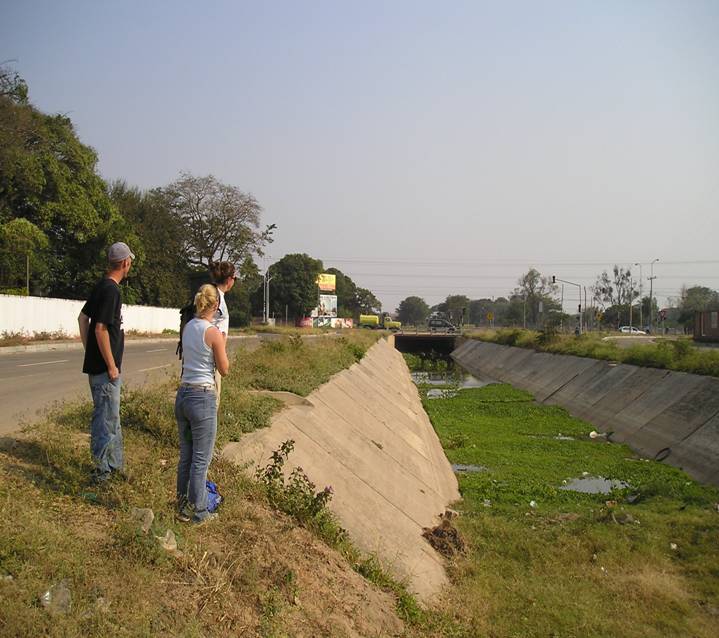

Existing
Conditions

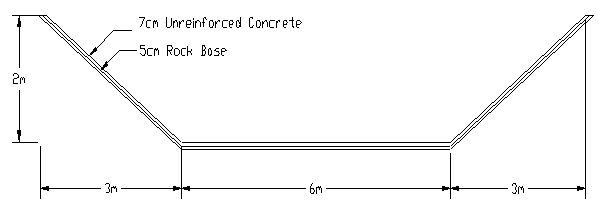

Urban open channel
in a trapezoidal configuration.
Side-slopes and base stabilized with 7 cm concrete and 5 cm rock
base.
No steel reinforcing material in the existing liner.
Cracked and crumbling side-slopes and completely deteriorated 3-5
meter sections.
Sandy-silty soil and high water table in wet season.
Abnormal storm water quality indicate fecal matter:
--average pH-8.39;
--average Phosphate Concentration-0.75 ppm Orthophosphate;
--average Nitrate concentration-0 ppm;
--colonies of Fecal Chloroform and E.coli TNTC--too numerous to
count.
Standing water = breeding ground for Malaria-carrying mosquitoes |
 |
Option

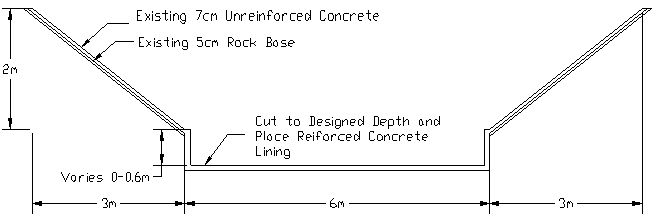

1: Remove and Lower Canal Base
Idea suggested
by the City Engineering Department of Santa Cruz.
-saw-cut and demolish existing canal base,
-excavate to the desired depth (max cut of 2ft),
-line the extended cross section with reinforced concrete.
Ruled out?RISK
of structural failure due to undermining the base of existing canal
|
 |
Option

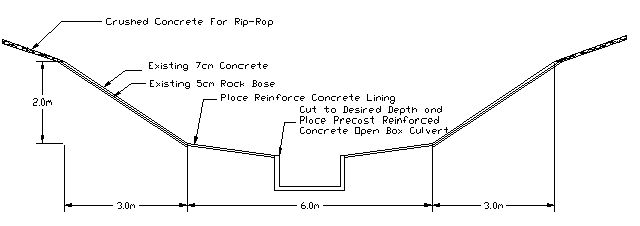

2: Trapezoidal Channel with Pre-Cast Pilot Channel
Salvages existing
sides
-Saw-cut and demolish existing canal base,
-Excavate pilot channel,
-Place custom pre-cast open box culvert and backfill,
-Cast-in-place reinforced concrete placed between top of pre-cast
section and toe of canal.
Cost: $750,000-$900,000
US
Ruled out ?
RISK, COST, unfamiliar construction and cross-section.
|

|
Most

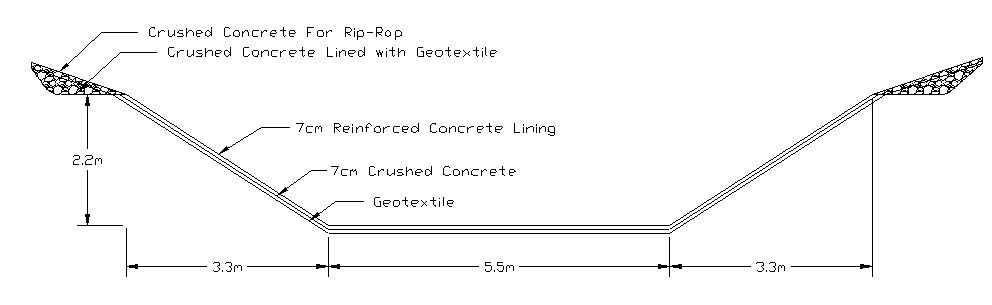

Feasible--Option 3: Complete Reconstruction of 8,400 ft (2,600 m)
of Canal
Demolition of
8,400 ft (2,600 m) of existing canal :
-Excavate and re-grade,
-Place non-woven geotextile fabric,

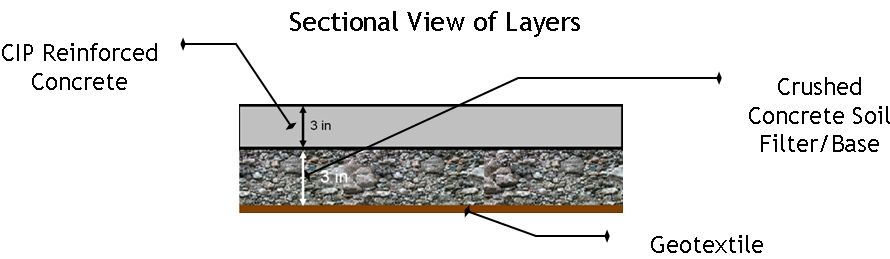

-Rublizie demolished concrete for 3 in (7cm) soil filter/base,
-Cast-in-place reinforced concrete liner 3 in (7 cm),
-Saw-cut contraction joints for groundwater pressure release,
-Bank stabilization and erosion control with excess demolished concrete
as Rip-Rap and geotextile.

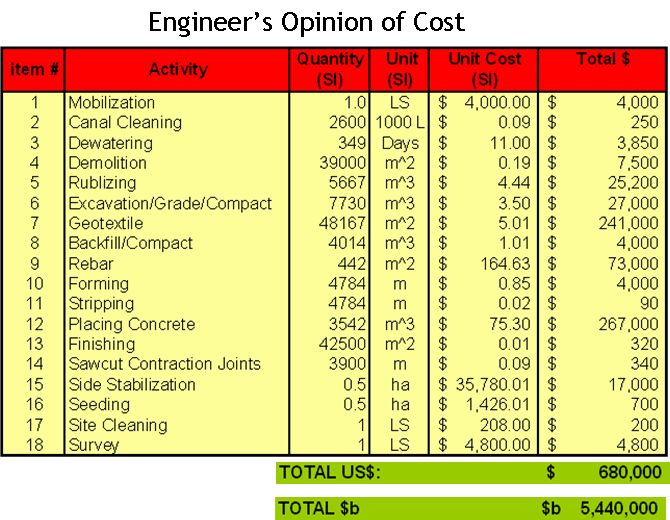

Cost: $680,000
US ($b 5.44 Million)
Completion time: 18 months (2 dry seasons-March to December)
Most feasible and sustainable solution.
|
 |

Note:
$200/month-Avg. Laborer Salary
$300/month-Avg. Operator Salary
$500/month-Avg. Foreman Salary
*Costs based on: Bolivian cost information, RS Means, duration
of project and construction experience.

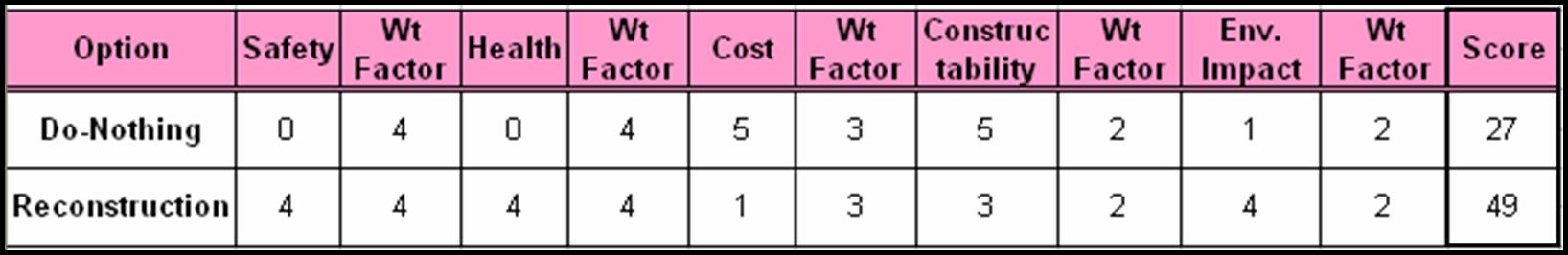

Decision Matrix Comparing Reconstruction with Maintaining Existing
|
Pros
and Cons of Reconstruction
Pros
Removes Unknown Risks Associated with Options 1&2
Uses Construction Methods Familiar to Santa Cruz
Corrects Existing Erosion Problems
Provides an Upgraded Canal with a 25-30 Year Life without maintenance.
Solves standing water problem
Provides sustainable solution
Recommendations
The final recommendation
of EMT is based on:
Future development
Ability to procure funding
Health and Safety
Existing canal life
Sustainability
The City may
also choose to forego this recommendation in lieu of seeking a more
suitable, less expensive solution.
If the City:
Plans to develop the swamp east of Doble Vía (Road),
Plans on paving more roads,
Plans to change the current runoff in any other way, or
Is unable to procure funding at this time,
It is the recommendation
of EMT that nothing be done at this time and the canal be re-evaluated
and redesigned for future increased flow within the next 10-15 years.

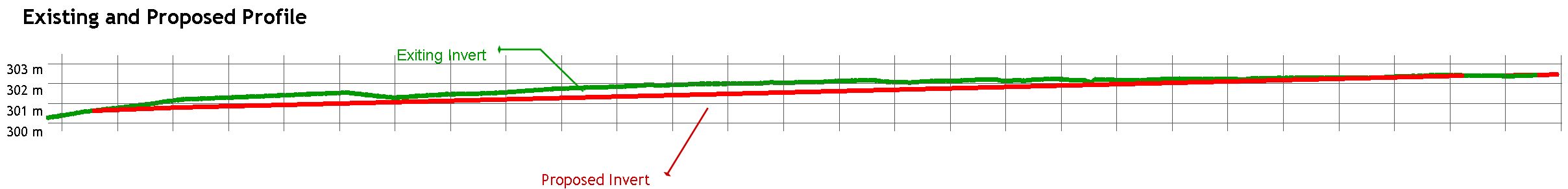

The proposed
reconstruction cross-section and gradient is based on current flows.
If none of the above is applicable, EMT recommends constructing
the proposed design, option 3. Since EMT believes the existing canal
will only be viable for 10 to 15 more years and the standing water
poses serious health and safety risks, complete reconstruction is
the only sustainable option investigated at this time.
|
|
|
|
Michigan Technological
University
Department of Civil and Environmental Engineering
1400 Townsend Drive
Houghton, Michigan, 49931 - 1295, USA
Department Phone: 1-906-487-2520
Department Fax: 1-906-487-2943
Department E-mail: cee@mtu.edu
© 2005 Michigan Technological University
