|
Septic
System for La Base
(resumens
de los informes en Espaņol
(PDF)
International
Senior Design: Santa Cruz, Bolivia
August
2005
S.T.R.8
U.P. Engineering
Lauren
Hubbell – Undergraduate, Civil Engineering
Matt Van Slembrouck – Undergraduate, Civil Engineering
Maureen Habarth – Undergraduate, Environmental Engineering

Background
In
August, 2005 S.T.R.8 U.P. Engineering traveled to Santa Cruz, Bolivia
to gather information needed to design an onsite wastewater treatment

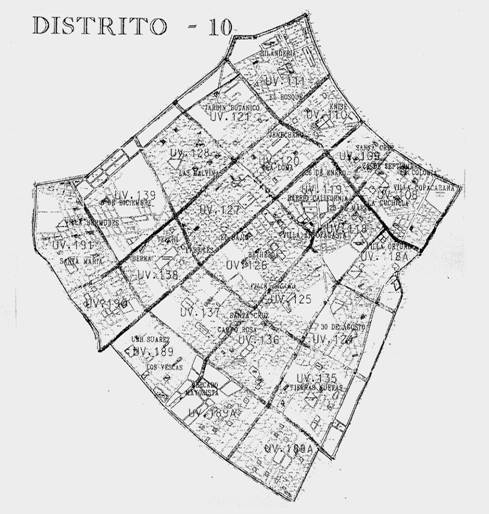

design for a local school, La Base. The school is located in UV
118 of District 10, just inside the 6th ring of Santa Cruz. The
school serves 1,240 students in grades Kindergarten through 8th
in three daily shifts. It is estimated that nearly 1,000 students
are turned away each year because of overcapacity.

|

Entryway sidewalk

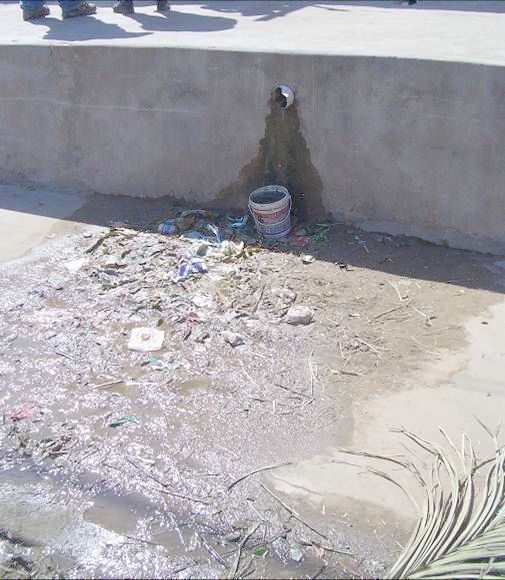

at La Base. The PVC pipe contains run-off water from school and
“grey water” from sink. The water tested at this pipe
was contaminated with sewage.

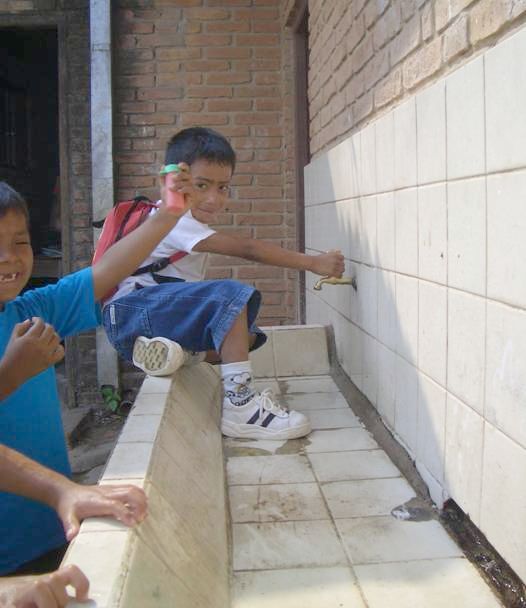

Child playing
in sink at La Base.

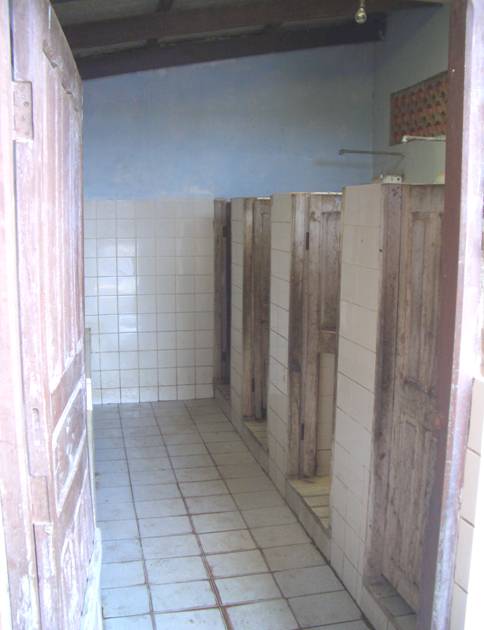

Toilet rooms

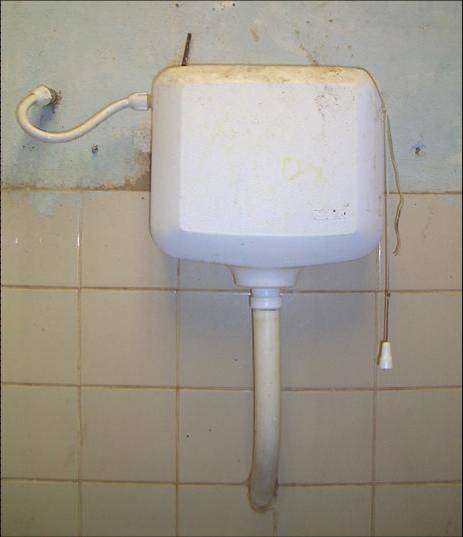

at La Base include Astra flush tanks and “squat” toilets.
There are currently 8 total toilets.
|
ONSITE
WASTEWATER
TREATMENT DESIGN
Problem
Statement
The
current wastewater treatment system at La Base School is of the
traditional Bolivian design. This system was installed 15 years
ago for an estimated 100 students and is currently failing. The
system is currently violating Bolivian codes and standards regarding
application rates of effluent and disposal of wastewater. S.T.R.8
U.P. believes the following factors are causing the failure:
- System
lifetime of 5-10 years exceeded
-
Current wastewater volume greatly exceeds system capacity
|

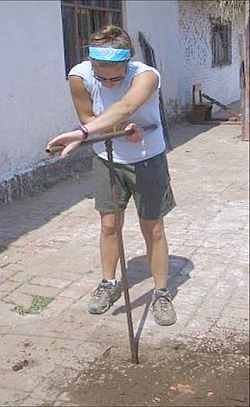

Matt

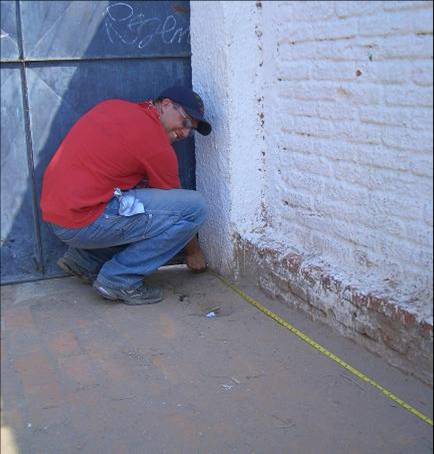

measuring the site layout

|
Data
Gathering
Onsite
Testing:
Site Layout

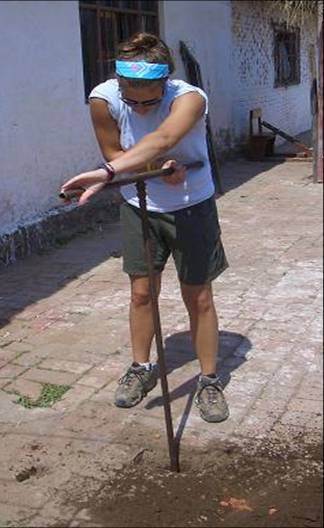

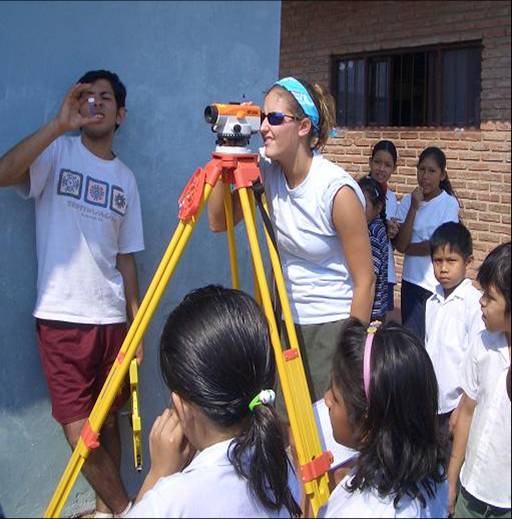

Soil Borings
Topographic Survey

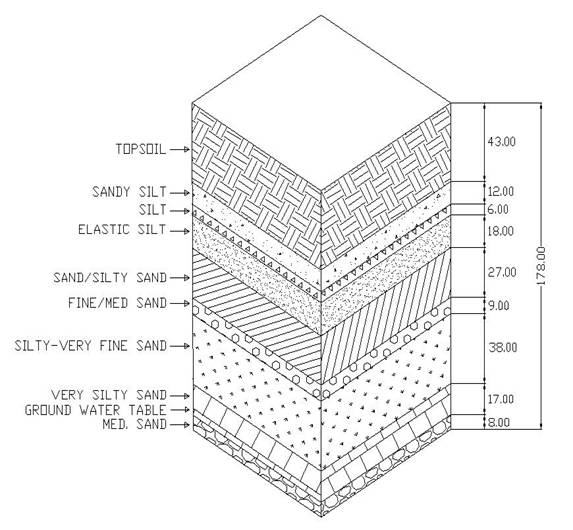

Soil boring
results showing mostly silty sand at La Base.

Topographic
Survey of site showed level elevations |

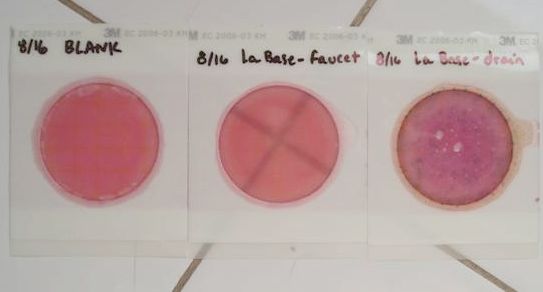

Drinking
water samples showed no growth of E. coli or total coliform bacteria.
However, the “grey water” sample (far right) contained
extremely high numbers of both E. coli and total coliform colonies.
These results are consistent with the results of the P/A test. |
Offsite

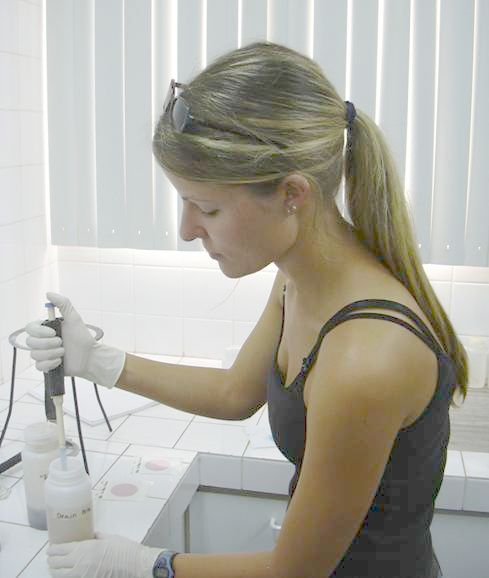

Testing:
Presence/Absence (P/A) Test
E.coli/Coliform Test

Right

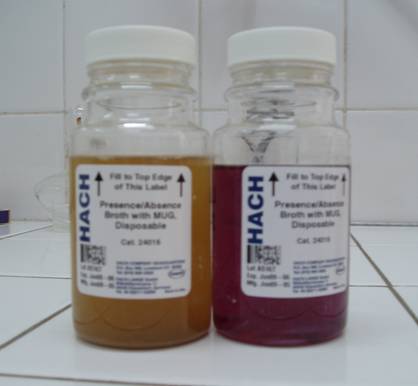

Bottle: Drinking water samples tested negative for the presence
of total coliform bacteria.
Left Bottle: The PVC effluent, or “grey water” sample
indicated the presence of total coliform bacteria in the sample.
These bacteria species are indicators of fecal contamination. This
condition is a health hazard to students and teachers who come in
close contact with this water daily.
|

Basic information
was gathered at meetings, including the parent’s concerns.

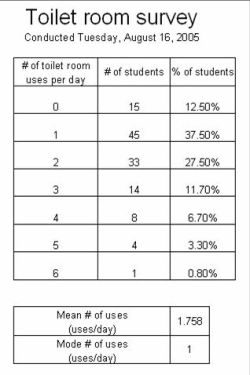

Right: Toilet
room survey showed that students used the bathroom 1.76 times per
day. This was combined with the flush tank volume to estimate the
24-hour flow to be 7,482 gal.
|
At
La Base:
Informational meetings with School Director and PTA
Toilet room survey  |
Traditional
Bolivian System

Three-component
system that includes and inspection tank, septic tank, and dry well
(“poso ciego”).
Advantages:
Familiar to Bolivians.
Can be covered with concrete.
Disadvantages:
Requires 6 poso ciegos for La Base.
High wastewater loading rate.
|

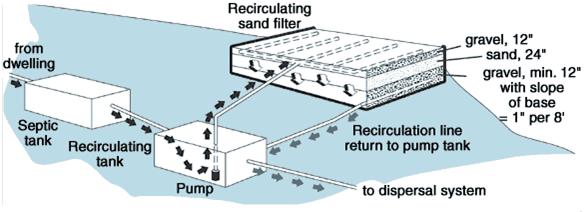

Recirculating
Sand Filter (RSF)

Effluent
is pumped from septic tank to a system of perforated pipes in a
sand filter. The wastewater passes through the system several times
before it is finally dispersed to a drainfield.
Advantages:
Higher application rate can be used in smaller area due to recirculation.
Disadvantages:
Requires several pumps
Unfamiliar to Bolivians.
|
Modified
Bolivian System

Similar
design to Traditional Bolivian System. The dry well has a modified
trench system that contains perforated pipes for distribution of
effluent.
Advantages:
Can be covered with concrete.
Requires only 2 poso ciegos.
Lower construction cost.
Disadvantages:
Requires a pump.
Can only treat 2,000 gpd.
|
|

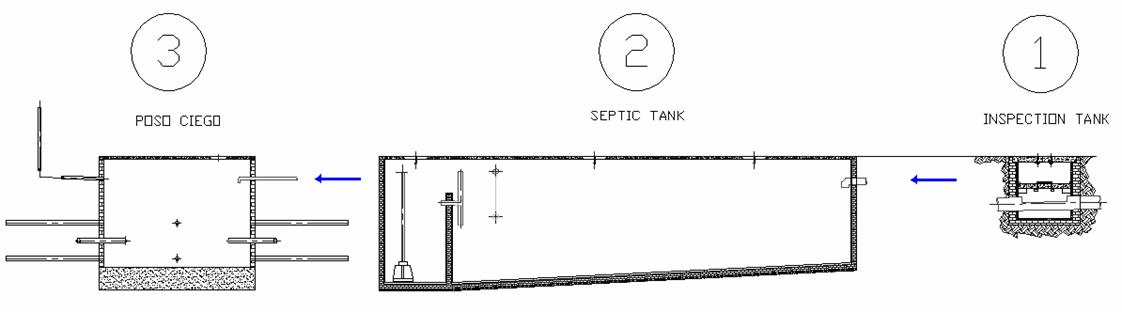

System
Layout
-
Inspection Tank
-
Septic Tank
10.5m x 2m x 2.5m
24-hour retention time
½ hP pump
-
Dry wells

Final

Site Layout

Modified

Dry Well (“Poso Ciego”)
2
dry wells
3.3
m diameter
2.1
m perforated pipes extending out from dry well.
|
Recommended
Design
S.T.R.8 U.P.’s final recommendation for La Base is the Modified
Bolivian System. The system first moves effluent through an inspection
tank used for maintenance purposes, then to a dual chamber septic
tank. Solids are removed in the first chamber of the septic tank and
cleaner effluent flows over a baffle to the second chamber of the
tank. The pump chamber uses a ½ hP pump to dose effluent approximately
6 times a day to the two 3.3m diameter, dry wells located in the courtyard
of the school. The dry wells are perforated to allow the effluent
to absorb in the soil for final treatment before it reaches the groundwater.
The design can handle 2,000 gallons of wastewater each day, so S.T.R.8
U.P. is also recommending La Base take part in a water conservation
program to reduce their daily flow. Examples of reducing wastewater
include reducing the volume of water per flush and the number of flushes
per day. An educational program was developed for La Base about water
conservation as part of the final design. The estimated construction
cost for the modified system is $6870 USD.
|
|
Future
Recommendations
S.T.R.8
U.P. Engineering’s future recommendations for La Base include
connecting to municipal sewer lines, starting a basic sanitation
and health program, and installing more toilets. The municipal lines
do not currently reach La Base, but are expected to within the next
15 years. The team suggests pushing the local government for these
lines and connecting as soon as possible because the Modified Bolivian
septic system is not a permanent solution.
The educational program includes water conservation, basic health
information, proper hand-washing techniques, and knowledge about
septic systems.
It is estimated that 10 toilets for girls and 10 toilets for boys
are needed to meet Bolivian standards at La Base.
|
