Map
Bridge Project
Team Members:
Amy Curtis – Project Manager, Civil Engineer
Michael Kalisz – Civil Engineer
Jeremy White – Civil Engineer

The beautiful Dominican countryside.

Current river crossing at low river level.
|
Suspended
Bridge Project, International Senior Design, Dominican Republic
CE 4905 Senior
Design Summer 2004
Slide Show Scenes of 2004 Projects
Introduction
The bridge project is a result of the international senior design project
at Michigan Technological University. Every year, two teams of 12 students
and their fearless leader Linda Philips, travel to the Dominican Republic
or Bolivia for 2 weeks to work on senior design projects and gain cultural
and foreign construction experience. This year the Dominican senior design
was broken down into 3 groups. 2 groups designed a spring water distribution
system, while the third group designed a suspended bridge for crossing
a river when flooded. The bridge group consisted of project leader Amy
Curtis, and team members Michael Kalisz, and Jeremy White. Surveying,
data collection, and preliminary design took place in the villages of
La Vereda and El Cercado, Republica Dominicana. Final design and report
preparations took place at Michigan Tech with the aid of its resources
and professors.
Problem Statement
Upon arrival in El Cercado, our team was met by MTU Masters International
student and Peace Corp volunteer for the area, Lyle Stone. Lyle presented
the bridge team with the problem facing the people of La Verada and the
surrounding villages. Every spring during the rainy season, a major river
to the area becomes heavily flooded and completely impassable for miles
around. The high waters prevent the people of La Vereda from going to
a large spring, which is one of the few sources clean water in the area,
and the people from the neighboring pueblos from crossing the river into
town in order to get supplies and have access to a paved road and transportation
to medical facilities. This leads people to try and cross a dangerously
swollen river in order to get their basic needs met.
|
Background
The Dominican Republic (La Republica Dominicana) is located south of the
United States in the Atlantic Ocean. It shares the Island of Hispaniola
with Haiti, occupying the eastern portion of the continent. The country
is divided into provinces, much like our states. The site of this project
is located in the village of La Vereda and the province of San Juan, which
is found at the south central portion of the Haitian border. The largest
nearby pueblo, the equivalent to what we call a town, is El Cercado, where
the design teams were housed. The northern end of the island of Hispaniola
lies on the borders between the North American and Caribbean tectonic
plates. This fault zone is quite active today providing earthquakes as
recently as a magnitude 4.4 on September 4, 2004. Hispaniola has a high
rate of erosion runoff which deposits many alluvium soils in the valleys
and along the rivers of the Dominican Republic. The region where La Vereda
is located is situated in one of these alluvial plains. Alluviums consist
of clays, silts, sands and gravels that are carried along by rivers and
deposited along its banks where ever the river flows. With the rivers
continually flooding and the severe erosion of the country side, most
of the soils left in these valleys are incredibly high in clay content.
The area of La Vereda and the surrounding villages are supported mainly
by farming. The local economy is poor with a strong dependence on crops
for food and family income. Farming is mostly subsistence in the area
of La Vereda, but is not sufficient to support a family. Small amounts
of surplus are sold at local markets for income. Additional wages are
earned through jobs in El Cercado and Los Conucos. Jobs are found in places
such as the hardware store, markets, and other farms.
|

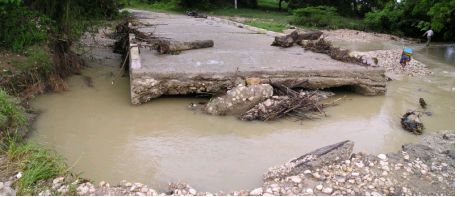

Flood damage to local
bridge after a minor flooding.

Mike testing the soil on the river bank.

Jeremy measures the river depth.
|
Site
Analysis
Three different crossing sites were visited and analyzed based on the
characteristics of each site. The sites were graded by soil quality, bank
stability, accessibility, and river location stability. The most important
and highest risk criteria is river location stability. These rivers are
small, but become incredibly fast and powerful during flood season. With
highly erodible soils, this leads to a lot of meandering rivers that constantly
change course. The bridge foundations must be placed such that they will
be free from river erosion and have a stable foundation for at least 20
years. Accessibility was a very important characteristic to consider because
if the bridge was to far out of the way, the Dominicans would probably
not use it at all, and if the path to the bridge was not stable and safe,
there would be fewer people willing to venture to the bridge to use it.
Finally the soil quality and bank stability are the important factors
to help keep the bridge lasting 20 plus years. The soil has to be strong
enough to hold the weight of the abutments, and the bank has to be stable
enough to prevent large amounts of erosion which could lead to failure
of the bridge abutments.
An in depth site analysis
was done for two of the three sites. The third site was rejected outright
due to it’s high chance for river relocation which would probably
undermine any attempts to build a bridge in that location. The first site
presented an excellent view of the soil layering in the area. There was
a 6’ vertical cut in the bank of the river that showed alternating
layers of rock and soil. Soil testing was performed on the bank using
a pocket penetrometer, and Torvane shear tester. Soil was tested at varying
depths and on both sides of the bank. Profiles of the site were drawn
up and a rough flow calculation at the site was taken using a 2 ½
gallon plastic bag. The bag was submerged empty, and airless, then the
bag was opened and timed until it was full. This was performed to give
a rough estimate of flow through the river channel.
This site was ultimately
rejected due to being placed only a few feet upstream from a 90 degree
bend in the river and very bad accessibility. It was not known how much
the path of the river would change in the coming years, but since it was
so close to an open corner, it was decided that the risk was too much.
And to top things off, the path to the site was through a rice field which
meant the trail was just a bunch of mud and fertilizer with frequent irrigation
ditch crossings that made travel difficult without any loads. It would
have been an unpleasant trip for the women carrying upwards of 7 gallons
of water along the trail. So the second site was ultimately chosen.
The stream depth at
low flow conditions was measured at 15” along the main channel where
the bridge crossing was proposed. This showed us where the center of the
river was, and where we needed the most base clearance for any trees or
debris floating down river during a flood.
The river crossing was measured to be 70 ft from bank to bank using a
measuring tape. One of the biggest design issues is the fact that the
opposing river banks are differ in height from 15ft above water level
to 5 ft. This meant either a tower would need to be created to even the
heights out or an angled bridge would need to be constructed. Either choice
would prove to be a challenge to design and build.
The first step after choosing the optimum site was to
survey the proposed site and create a bridge profile based on the current
stream height and river bank elevations. Surveying in the Dominican Republic
was a little primitive by today's standards, but was more then effective
enough to provide an accurate layout of the site. The survey crew consisted
of a three person team, an Abney level and a 100’ tape measure.
The person with the tape measure walks out a distance until the shooter
with the Abney level was able to sight in on a feature of the other persons
face. This height of the facial feature and Abney level from ground were
recorded. For our survey, it was the base of the measurers nose and upper
lip. The vertical angle to the measurers facial feature and distance from
the shooter to measurer were recorded. A straight line along the bridge
centerline was eyed and shot using this method both backwards and forwards.
By combining the heights, angle of sight, and distance measured, an accurate
horizontal and vertical profile was established. |

Site 2 Surveying: Mike Shoots to Jeremy with the Abney level, while Amy
records.
The second site visited was located along a well traveled and dry dirt
path, which solved our accessibility problems. The site was offset about
800 ft. from the main road through La Verada, which added to the convenience
of the location. The soils were tested again, and the results ended up
a little higher then site one which helped us further decide on this site.
The location of the abutments would be approximately 150 ft downstream
of a slight bend in the river path, which concerned us at first. A more
detailed look at the river path showed that both sides of the river were
heavily vegetated and though there were some signs of erosion, it was
apparent that the river had been on this present path without much meandering
for quite some time. The bridge site was located near the beginning of
a nearly ¼ mile long straight stretch of the river. The river banks
were both overgrown with trees up to 15” in diameter that grew straight
up with no major bends in the trunk suggesting that the banks hadn’t
been eroded away beneath the trees and that the trees started growing
in the same spot as they now occupy on the bank. This satisfied our bank
stability criteria by proving that the bank hadn’t moved more then
a few inches in at least 10 years.
Planning
and design started immediately after all the testing and surveying was
completed. Lyle Stone and Father John Cervini of the local catholic church
assisted in helping to compile a list of requirements that the bridge
would need to meet in order to serve the public interest of the people
of La Vereda. The requirements were to allow a bridge wide enough so 2
people could pass side by side, the bridge would need to be stable so
as to not sway when people walked upon it and cause them to loose their
balance, a way to provide a handrail system that connected to the walkway
is a way to prevent anyone from falling into the river below, and if possible,
be able to handle the weight of a medium sized cow or burro in case the
locals needed the animals to help transport goods or people in need of
medical treatment. |

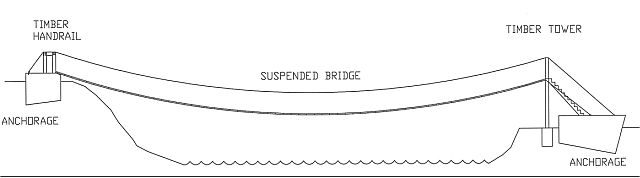

Side View of Planned Bridge and Profile of River
|
Design
Most of the design ideas and procedures came from a book in the MTU Library,
entitled “Survey, Design, and Construction of Trail Suspension Bridges
for Remote Areas”. Inside this book listed proven methods for calculating
cable sag, abutment size and amounts of materials based on bridges that
had been built in southern Asia. This book was a most valuable resource
along with other textbooks and the help of many MTU professors, such as,
Stan Vitton, William Bulleit, George Dewey, Bogue Sandberg, and our beloved
senior design professor, Linda Philips.
The design was split up into three parts.
Amy Curtis was responsible for calculations of cable sag, effects of temperature
on the steel, tension and cable design, and connections design. Mike Kalisz
was responsible for the profile drawing of the bridge in AutoCAD, slope
protection, walkway plank design, and initial specifications. Jeremy White
was responsible for the foundation analysis, anchorage design and gabiones
design.
The full design process started upon return to the United States with
all three team members located at least 7 hrs apart from each other for
the duration of the summer and fall design period. Work was shared and
distributed through many e-mails, instant messages and phone calls. The
ability of the team to overcome such a large distance obstacle showed
our determination to see this project through to hopeful construction
in the spring of 2005.
Dominican concrete mixers
|
 |
 |
Amy and Linda
working on cable design.
|
Father John Cervini,
whom without his help, these projects in the Dominican would not be
possible.
|
Along
with the calculations for the bridge design itself, many other logistical
problems arose. The design needed to be flexible enough to adapt to the
changes of the building site one year after the initial survey. The bridge
had to be designed to be able to be built in under 14 days. That includes
excavation, concrete pouring, plank assembly cable tensioning and anchoring
and final assembly.
The main goal of the design was to be as simplistic
as possible, yet still be able to meet strength and dimension requirements.
Another problem that had to be solved through design was the height difference
of the two river banks. With the lower bank being only 5 ft above the
river height, it was impossible to have the bridge at an incline and still
meet freeboard requirements for clearance underneath the bridge. A creative
solution was devised using the Survey, Design, and Construction of Trail
Suspension Bridges for Remote Areas book. A wooden tower will be constructed
on top of the lower bank’s abutment and will bring the bridge level
with the higher bank in order to create enough clearance underneath the
bridge. A set of stairs will be built leading up to the tower. The only
problem with this design, will be that the animals will probably not be
able to be brought across the bridge now as they would have a hard time
climbing up and down the stairs. One cost saving measure will be to use
boulders from the river as ballast in the abutments. The rock will greatly
reduce the amount of concrete needed, thereby saving a lot of money and
time. Also, the slopes will be grown with native plants as part of the
slope protection, and will hopefully be able to inspire some locals to
think more environmentally in order to reduce the severe soil erosion
problem in the country.
|

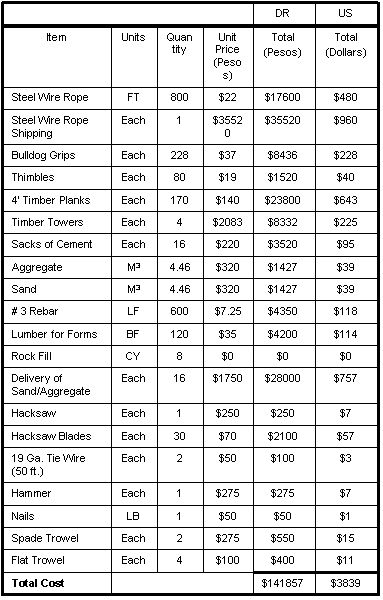

Cost
Summary
|
Summary and Conclusion
A bridge is needed
in the village of La Vereda over the Rio Valle Juelo. It is necessary
to protect the men, women and children from death due to floodwaters that
occur during the annual rainy season. This river has proved to be fatal,
just as many just like it during the floods of June 2004. The loss of
life and supplies can be prevented through the construction of a suspended
bridge. The bridge will be constructed of ¾ inch stainless steel
wire rope and connections, 2” x 6” x 4’ timber floor
planks, a timber tower, concrete and rebar anchorages, native cobble bank
protection, and trench slope protection. Material cost of the bridge reaches
a total of $3900 before donations. An additional cost of approximately
$7,000 is required to fund travel and living expenses for the designers
that will be necessary on site for anchorage placement and construction
aid. Sources for these funds will include both material and financial
donations.
We would like to thank,
John Cervini, Linda Philips, Lyle Stone, Matt Niskanen, Dr. Robert Baillod,
Dr. Stan Vitton, Dr. William Bulleit, Dr. George Dewey, Dr. Bogue Sandberg,
and Loos & Co. |
|
|
|
Michigan Technological
University
Department of Civil and Environmental Engineering
1400 Townsend Drive
Houghton, Michigan, 49931 - 1295, USA
Department Phone: 1-906-487-2520
Department Fax: 1-906-487-2943
Department E-mail: cee@mtu.edu
© 2004 Michigan Technological University
The sale or commercial use of Illustrations, photographs and graphic images
presented on this site is not permitted. Educational uses are permitted,
provided credit is given to sources.
|
|
